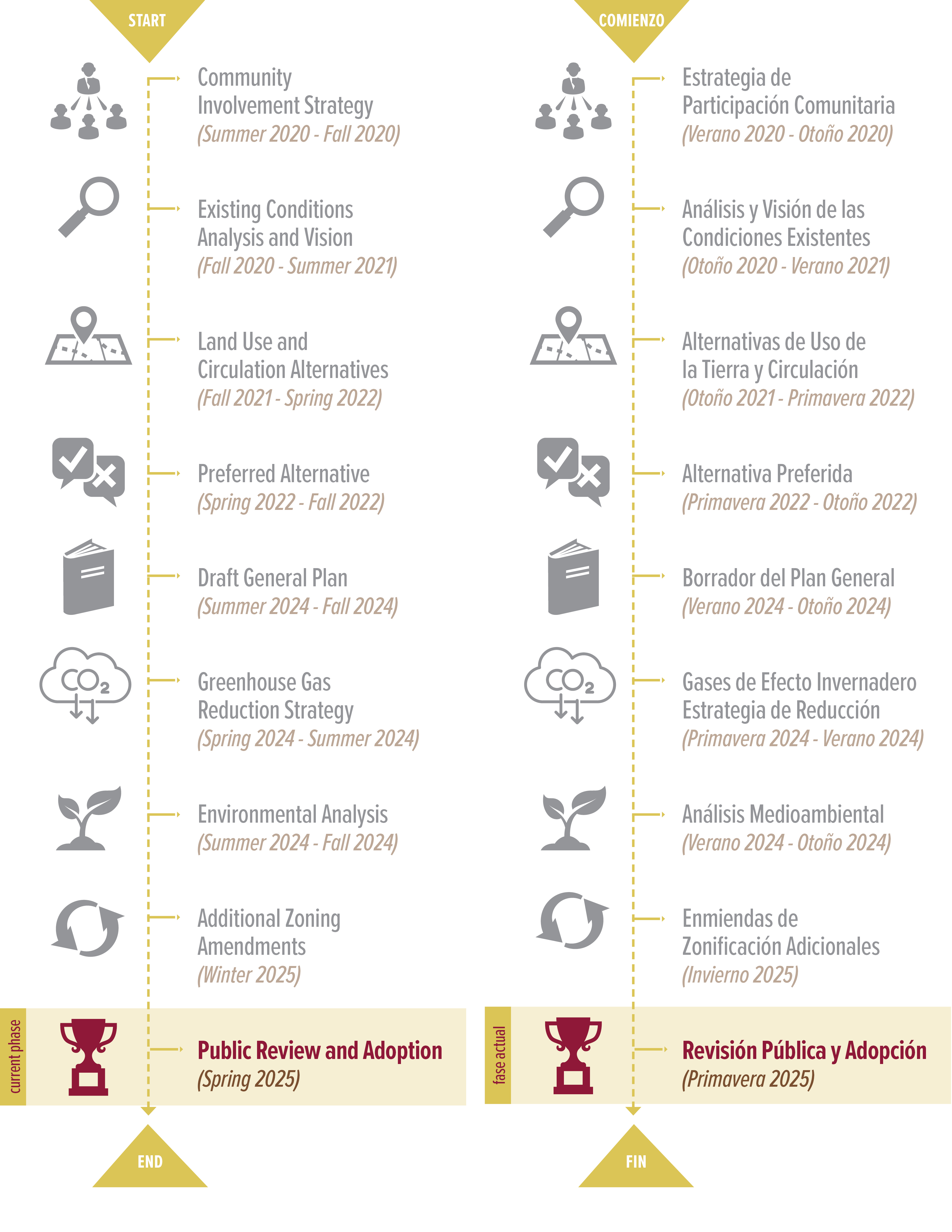

The General Plan Update project is estimated to take three years to complete. This is due to the extensive analysis and community discussions that will take place during each major phase of the project. Please click the following links to view the latest detailed version of the project schedule:



Schedule Diagram
